A densely populated six-layer board after reflow, chip components and copper traces receding into shadow under raking light
Contract electronics manufacturing · since 2009

Boards built to spec. From first prototype to 45,000 a month.

SMT, through-hole and mixed-technology assembly with in-house 3D AOI, X-ray and functional test in San Jose, California. DFM review in 24 hours, firm quote in 48.

SMT lines
6
Smallest placement
01005
Monthly output
45,000 units
DFM turnaround
24 hours
02 / Scope

What we take on, and what stays with you

We are a contract assembler, not a broker. Buyers hand us a Gerber set, a BOM and a quantity break; what comes back is a tested assembly with the process data behind it.

FLASHPOINT PCBA builds printed circuit board assemblies for hardware teams that would rather not change supplier between engineering samples and volume. Across 42,000 sq ft in San Jose and 18,000 sq ft in Penang we run six SMT lines on three shifts, 210 people, and a component store holding 4,000 unique part numbers under ESD control.

The process window is published rather than negotiated per enquiry. We place 01005 chips and 55 mm connectors on the same line, hold 0.35 mm pitch BGA and 0.3 mm CSP, and build panels from 20 × 20 mm up to 610 × 510 mm with a 0.4 mm to 6.4 mm finished thickness. Placement accuracy is ±35 µm at 3σ for chip parts and ±25 µm at 3σ on fine pitch.

Everything after the bare board happens in this building: laser-cut stencils turned in 4 hours, 3D SPI on 100 % of boards with a CpK ≥ 1.67 gate, 12-zone nitrogen reflow held to ±1.5 °C profile repeatability, two wave pots and three selective solder robots for 0.6 mm to 6.4 mm hole fill, inline 3D AOI at three points, 2D and 3D CT X-ray, aqueous cleaning verified to 1.56 µg NaCl-eq/cm², conformal coating to IPC-CC-830, and functional test on fixtures we design and build ourselves.

What stays with you is the design and the tooling. Stencils, test fixtures and programming transfer to the customer after first article, so a second source becomes a commercial decision rather than a technical rebuild.

Plants
2 · San Jose CA, Penang MY
Floor space
42,000 sq ft · 18,000 sq ft
People
210 · 150 San Jose, 60 Penang
SMT lines
6 · four volume, one NPI
Placement rate
30,000 components/hour per line
Combined placements
14 million per month
Board size
20 × 20 mm to 610 × 510 mm
Active programmes
130 · 38 in NPI
Workmanship
IPC-A-610 Class 1 / 2 / 3
03 / Capabilities

Seven capabilities, each with a hard limit

Every card below names the number that decides whether your board fits. If it does not fit, we say so in the DFM report rather than on the third build.

All capability detail
04 / Quality spine

Where a board can be stopped

Four gates sit between a printed panel and a shipped assembly. Each one has a threshold, a record and an owner, and none of them can be waived by a delivery date.

  • G1 Paste print verificationInline 3D SPI measures deposit volume, area and height on 100 % of boards. A panel below CpK ≥ 1.67 is stopped and the stencil is cleaned or remade. CpK ≥ 1.67
  • G2 Placement and reflow±35 µm at 3σ chip accuracy and ±25 µm at 3σ fine pitch, then a 12-zone nitrogen profile held to ±1.5 °C across the panel. Thermocouples are attached to every new assembly. ±1.5 °C
  • G3 Joint inspectionInline 3D AOI after reflow and post-depanel, with 2D plus 3D CT X-ray on every BGA, CSP and LGA. Voiding above 25 % per IPC-A-610 sends the assembly to cross-section. void ≤ 25 %
  • G4 Cleanliness and finishInline aqueous cleaning with ionic contamination tested to 1.56 µg NaCl-eq/cm² against J-STD-001, then selective conformal coating to IPC-CC-830 where the assembly calls for it. 1.56 µg/cm²
05 / Order flow

How a job moves through the plant

  1. 01

    RFQ intake

    Gerber, drill, BOM with manufacturer part numbers, quantity breaks and test requirements. An engineer reads the package the same working day.

  2. 02

    DFM and quote

    A written DFM report in 24 hours and a firm turnkey price in 48, with alternates listed and their lead times stated.

  3. 03

    NPI and first article

    Stencil in 4 hours, programming, then a pilot run 15 working days after DFM sign-off with a full FAI report and a golden sample.

  4. 04

    Production

    Line assignment by volume, SPI and 3D AOI at every gate, X-ray on area-array packages, and MES records written per serial number.

  5. 05

    Test, pack, ship

    Fixture test or burn-in, certificate of conformance, ESD bag with desiccant and humidity card, then DDP or DAP to your dock.

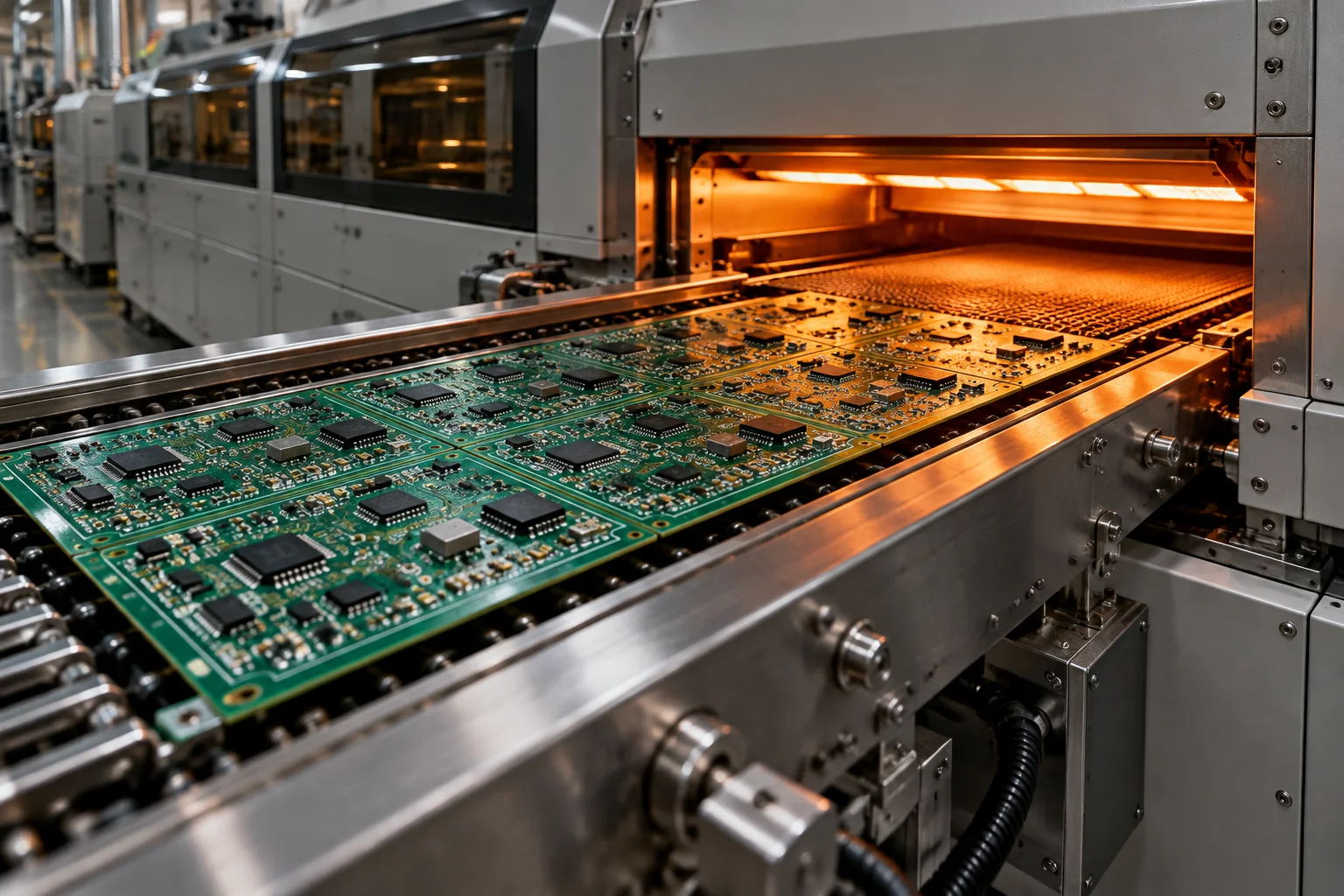

A panel of boards riding stainless conveyor rails into the mouth of a twelve-zone reflow oven
The volume lines run panels through a 12-zone nitrogen oven at ±1.5 °C profile repeatability.
06 / First 48 hours

What happens in the first two days

Most of the risk in a new build is decided before anybody buys a component. Here is where the first 48 hours go.

The package is logged and an engineer opens the Gerber against the BOM by hand. Panelisation is proposed, fiducials and tooling holes are checked, and the land patterns are compared with IPC-7351B density levels. Anything that will not survive the printer is flagged with the measurement that broke it, not with an opinion.

By the 24-hour mark you have a written DFM report: changes that are required, changes that are optional, alternates for parts with long lead times, and the effect of each on unit price. A firm quote follows within 48 hours of a clean BOM and Gerber set, itemised by material, placement, test and tooling. NRE is $0 on a standard single-sided SMT build; fixture NRE is quoted separately and credited back at 5,000 units.

07 / Evidence

New product introduction and inspection, in practice

Two things decide whether a programme ramps cleanly: how the first article is built, and how much of the process is actually measured.

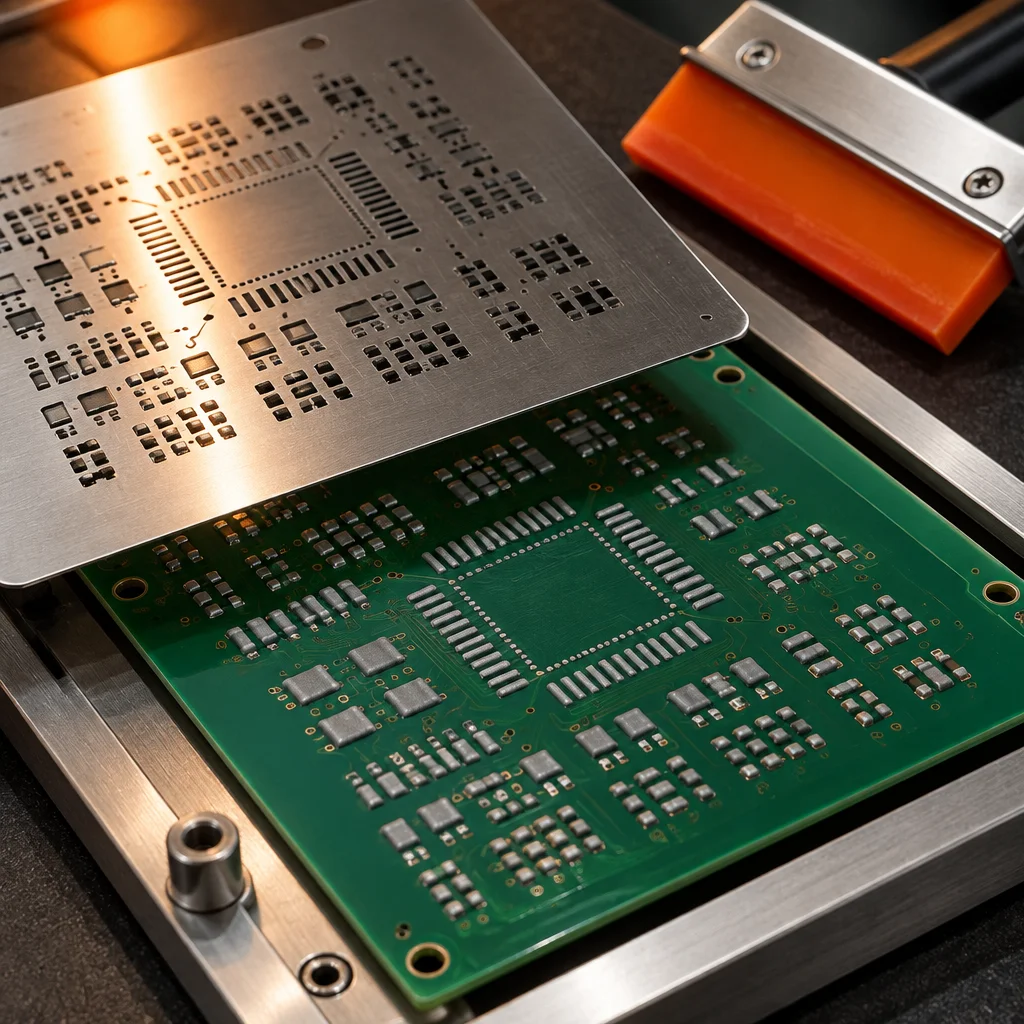

A laser-cut stainless stencil lifted clear of a board already printed with rows of grey solder paste

NPI on a dedicated line

One of the four San Jose lines is reserved for NPI and flex work, so a 5-board prototype is not queued behind a 20,000-unit release. Stencils are laser cut in 4 hours from your Gerber. The first article carries X-ray, cross-section and dimensional data, and 38 programmes are in NPI at any given time.

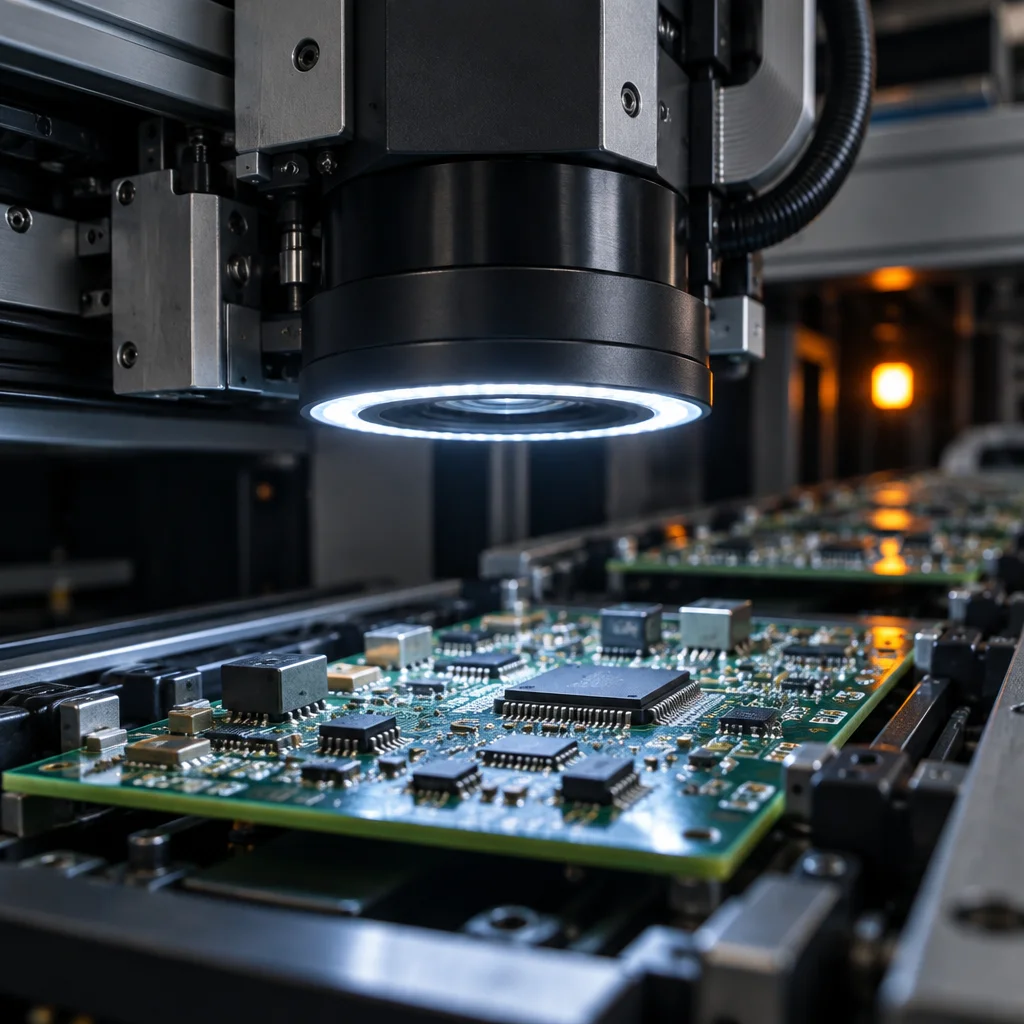

An inline AOI camera head with its ring light on, hovering above a populated board on the conveyor

Measurement, not sampling

3D AOI runs after print, after reflow and after depanel. X-ray covers every BGA, CSP and LGA, with 3D CT where voiding or head-in-pillow is a risk. Functional test runs on fixtures we machine and program in-house, and every result is stored against the board serial number for 10 years.

08 / Industries

Sectors we build for, and the extra controls each one adds

All industries
09 / Capacity and terms

The numbers a buyer asks for first

Monthly output45,000 units
Active programmes130
Customers since 2009400+
Records retained10 years
DFM report
24 hours
Firm quote
48 hours
Prototype, 5–50 boards
5–8 working days
Prototype, consigned parts
8–12 working days
NPI pilot run
15 working days
Production repeat order
3–4 weeks ARO
Turnkey ramp, full kitting
4–5 weeks ARO
MOQ, prototype
5 boards
NRE, standard single-sided SMT
$0
Warranty
12 months on workmanship

Payment terms are Net 30 with approved credit, Net 15 on a first order, and card accepted under $10,000. Tooling — stencils, test fixtures and programming — belongs to the customer after first article. Certificate copies and facility codes are released under NDA on request.

10 / Questions

What buyers ask before the first order

Prototypes run on the NPI and flex line in San Jose, one of the four lines on that floor. When a design releases to volume it moves to a volume line with the same stencil, the same fixture and the same process engineer, which is why the first-article data still applies. The 5-board minimum applies to prototypes; there is no MOQ on a production repeat order under an existing programme.

The DFM report lists every line on the BOM that is end-of-life, single-sourced or quoted beyond 16 weeks, together with a cross-reference candidate and the qualification each one needs. We buy from authorised or franchised distribution only, hold bonded stock for repeat programmes, and model last-time-buy quantities against your forecast before a part disappears.

Whatever the drawing calls for. IPC-A-610 Class 2 is the default for industrial and consumer work, Class 3 for medical, aerospace and any assembly with a documented reliability requirement. The class changes the acceptance criteria on fillet height, voiding and cleanliness, so it is fixed at DFM sign-off rather than at final inspection, and the 12-month workmanship warranty is written against that class.

Yes, with two weeks of notice so the line you want to see is actually running. Customer audits, source inspection and witnessed first articles are routine across the 130 active programmes. Audit rights, inspection methods and the notification window for a non-conformance are written into the quality agreement rather than left to good intentions.

A macro field of laser-cut stencil apertures over a bare copper ground pour, reading as an abstract graphite and copper texture

Send the Gerber and the BOM. Get a DFM report in 24 hours.

An engineer reads every new package. You will hear back with what we would change, what it costs and how long it takes — before you commit to tooling.

DFM report24 hours Firm quote48 hours Prototype MOQ5 boards
